Our Process

Our standard installation workflow, the same process we teach and support.

Video: 15-Step Installation Process (Spanish)

A quick walkthrough of our standard install sequence — from concrete prep and base coat through flake broadcast and polyaspartic topcoat. Note: This video is in Spanish. The full 15-step process is listed in English below.
Step-by-Step Overview

Our 15-Step Installation Process.

A standardized, repeatable system—from concrete preparation through final cure. Exact materials, ratios, and working times vary by product and site conditions. Always follow product TDS/SDS and training guidance.

  1. Surface Inspection & Repair Inspect the concrete for cracks, spalling, contamination, moisture issues, or previous coatings. Complete all necessary repairs before coating begins.
  2. Initial Mixing (Primer / Base Coat – per system spec) Mix and apply the primer or base coat according to product specifications and working time requirements.
  3. Protect Adjacent Surfaces Mask walls, doors, transitions, and any surfaces not receiving coating to prevent contamination or staining.
  4. Equipment & Site Setup Stage all tools and materials onsite. Confirm adequate lighting, ventilation, and workspace access before mechanical prep.
  5. Electrical Verification (as needed) Confirm power availability and continuity to support grinders, vacuums, and application equipment without interruption.

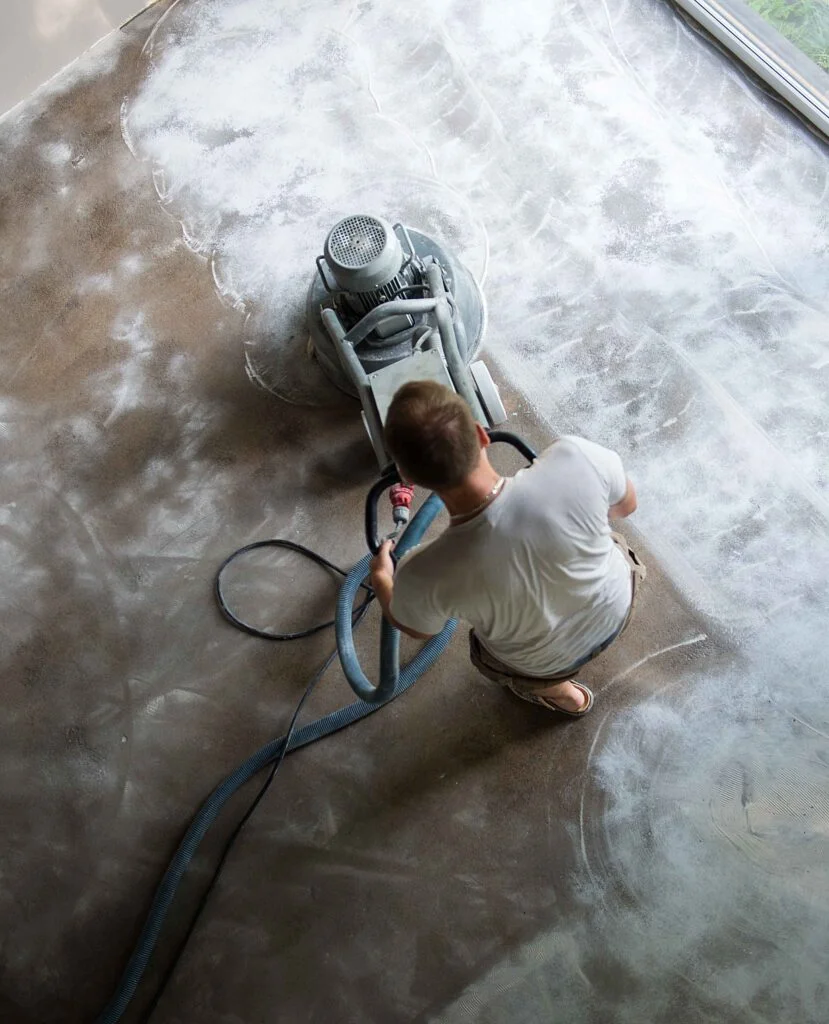

  6. Mechanical Surface Preparation Grind or abrade the slab to open concrete pores and achieve a consistent surface profile for proper adhesion.
  7. Dust Removal Vacuum the entire surface thoroughly. The slab must be completely clean and dust-free prior to coating.
  8. Product & Tool Preparation (Build Coat – per spec) Prepare squeegees, rollers, and materials before mixing. Mix build coat components per product specifications until uniform.
  9. Perimeter Cutting & Detail Work Cut in edges and detail areas first to ensure clean transitions and full perimeter coverage.

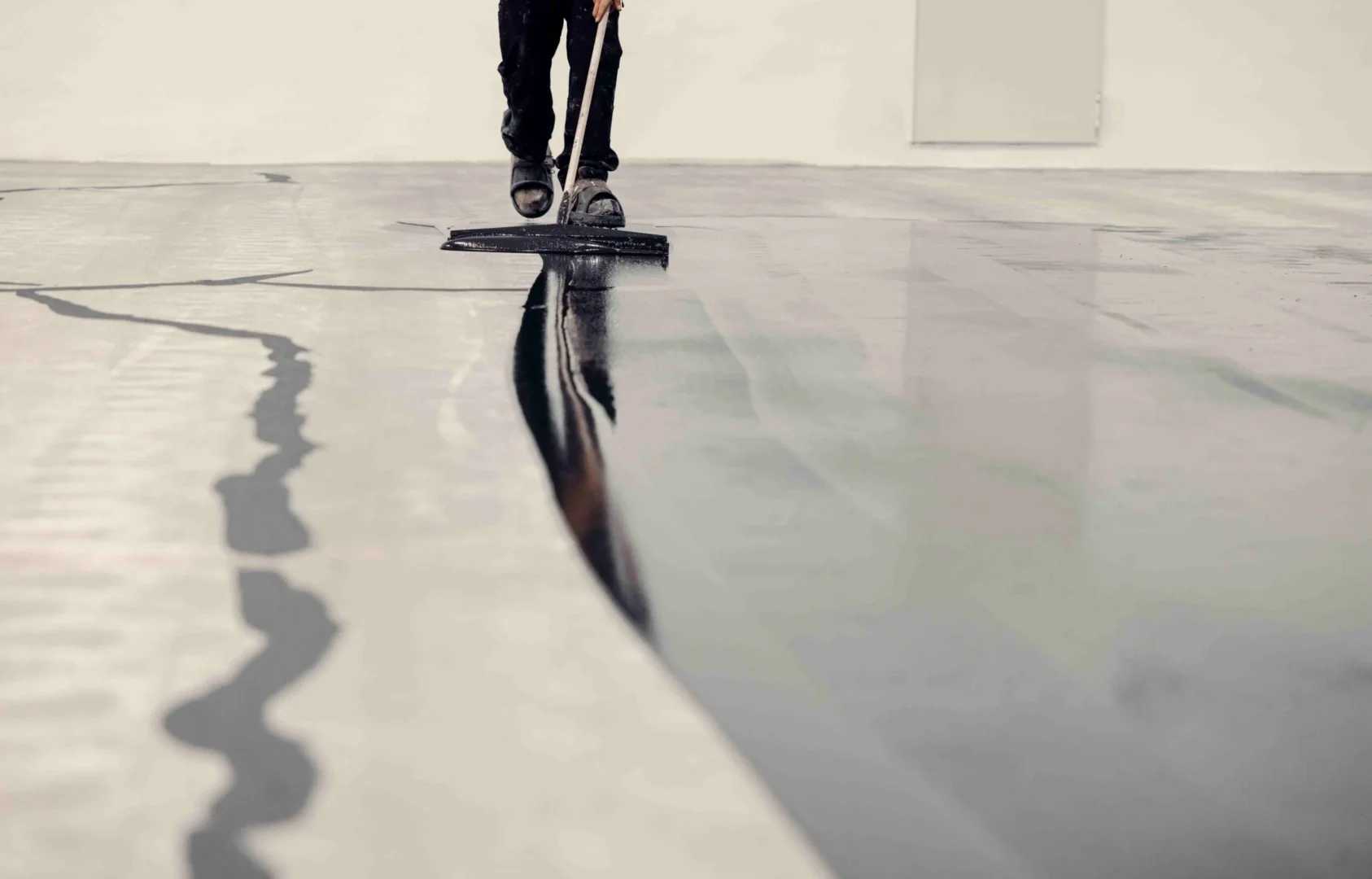

  10. Build Coat Application Pour manageable sections and spread evenly using a squeegee, maintaining consistent coverage and avoiding puddling.
  11. Back-Rolling Immediately back-roll behind the squeegee (typically cross-hatch) to level the coating and unify texture.
  12. Decorative Flake Broadcast (if used) Evenly broadcast flakes across the surface at the specified rate for the selected finish.
  13. Cure, Flake Removal & Surface Refinement Allow the coating to cure until ready. Remove loose flakes by sweeping or vacuuming, then scrape or sand as required to refine the surface.
  14. Topcoat Mixing & Application (per spec) Mix and apply the topcoat according to product specifications. Spread and back-roll to seal the system and achieve a uniform finish.
  15. Final Cure & Cleanup Remove all masking, clean the work area, and perform a final inspection. Return-to-service timing varies by system and conditions.
